Accounting for Real Estate Developers: A Guide

Introduction

Real estate developers spend money for years before they see a dollar of revenue. Land acquisition, entitlements, design fees, and site work all happen while the project sits on the balance sheet as an unrealized cost, not a sale.

That timing gap creates a problem most bookkeeping systems were never built to solve. A single-entry ledger tracking "income minus expenses" tells you almost nothing about whether Phase 2 of a 40-unit build is on budget.

Development work adds layers most ledgers never see: multiple entities, construction draws, shifting cost estimates, and complex financing. Miss a retainage entry or misclassify interest, and project margins can swing by six figures.

This guide walks through US GAAP project accounting, cost classification, the development lifecycle, financial reporting, cash flow, software selection, and internal controls—so you can build a system that reflects what's happening on the ground.

Key Takeaways

  • Project-level cost, variance, and cash flow tracking beats company-level rollups for developer decisions.
  • Keep capitalization, revenue recognition, loan accounting, and entity reporting aligned with current US GAAP and tax rules.
  • Monthly reconciliations, work-in-progress schedules, and lender-ready reports catch issues before they compound.
  • Match software and outsourced support to project complexity and reporting needs—not the lowest sticker price.

What Makes Accounting for Real Estate Developers Different?

Development accounting means tracking acquisition, pre-development, construction, financing, sales, leasing, and close-out activity by project and by legal entity. It's a different discipline than standard business accounting, and treating it as the same thing is where most cost overruns start.

Ordinary businesses recognize revenue and expenses in roughly the same period. Developers don't have that luxury. A single project might run 18 months to five years, with:

  • Enormous upfront cash outlay before any revenue event
  • Estimates that shift as construction progresses
  • Multiple financing sources with different terms and covenants
  • Construction commitments that aren't yet liabilities but still need tracking

Bookkeeping captures what was spent. Accounting interprets that history so you can tell whether the project will hit its margin target—and what to change if it won't.

The Cost of Getting This Wrong

Weak development accounting shows up as:

  • Misstated project profitability that isn't caught until the sale closes
  • Cash shortages despite an "on paper" profitable project
  • Lender reports that don't reconcile to the general ledger
  • Unnecessary tax exposure from inconsistent capitalization
  • Investors who lose confidence after unexplained variance reports

The fix starts with a documented chart of accounts and cost-code structure that separates:

  • Land
  • Hard costs
  • Soft costs
  • Financing costs
  • Selling costs
  • Corporate overhead
  • Shared expenses

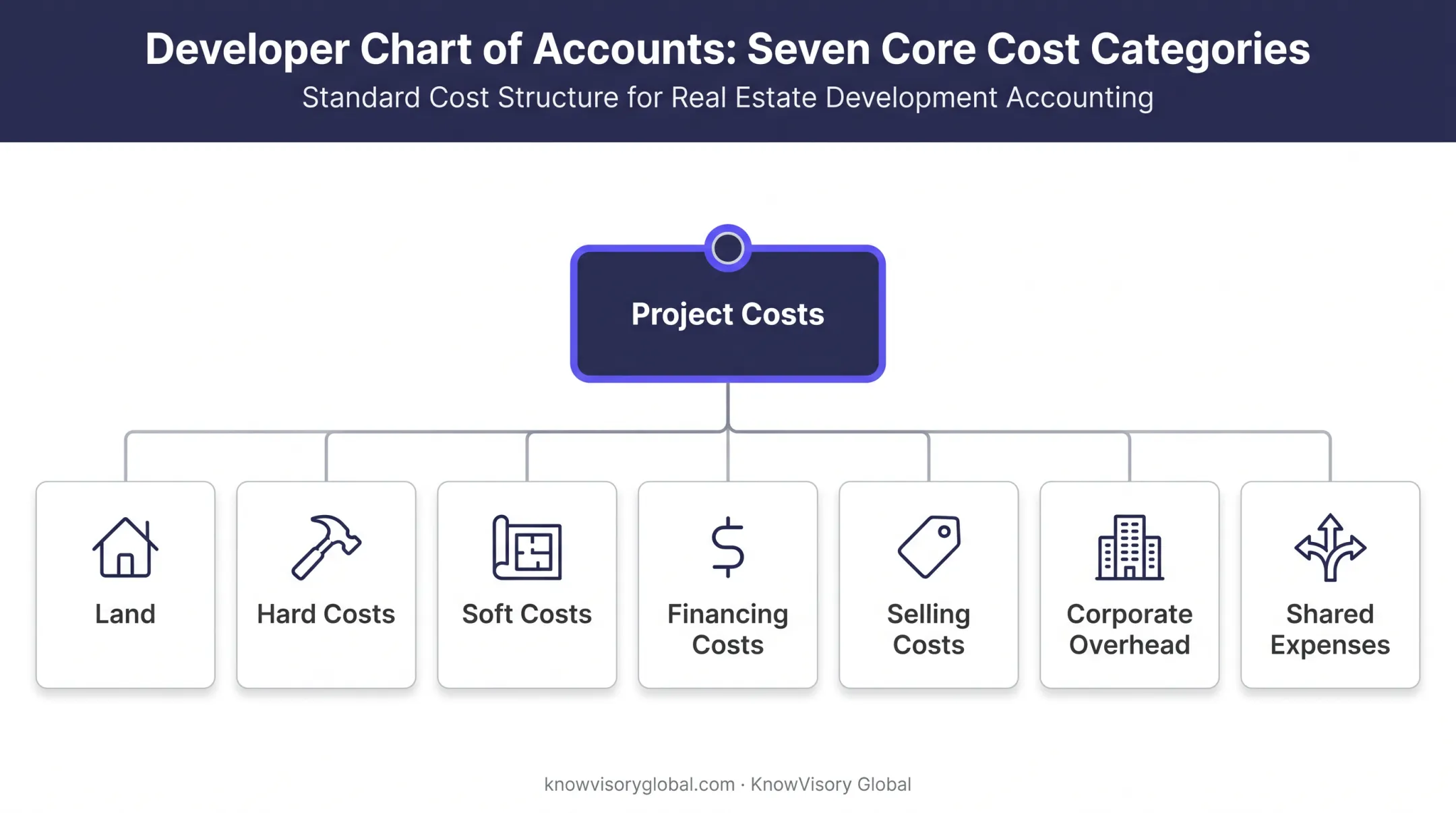

Real estate development cost category breakdown chart of accounts structure

Many contractors and developers build this structure with the CSI MasterFormat system. It standardizes divisions like site work, concrete, framing, electrical, and finishes so costs stay comparable across projects.

Core Accounting Principles Developers Need to Apply

Four technical principles govern almost everything else in development accounting—capitalization, construction-in-progress, interest treatment, and job costing—while accrual accounting sets when those costs hit the books.

Capitalization vs. Expensing

Under ASC 970, costs clearly associated with acquiring, developing, or constructing a project generally get capitalized. Common capitalizable costs include:

  • Land acquisition
  • Directly attributable construction costs
  • Design and engineering fees
  • Permits and project-specific professional fees

Costs that typically get expensed as incurred:

  • Corporate administration unrelated to a specific project
  • General office overhead
  • Marketing costs that can't be tied to one development

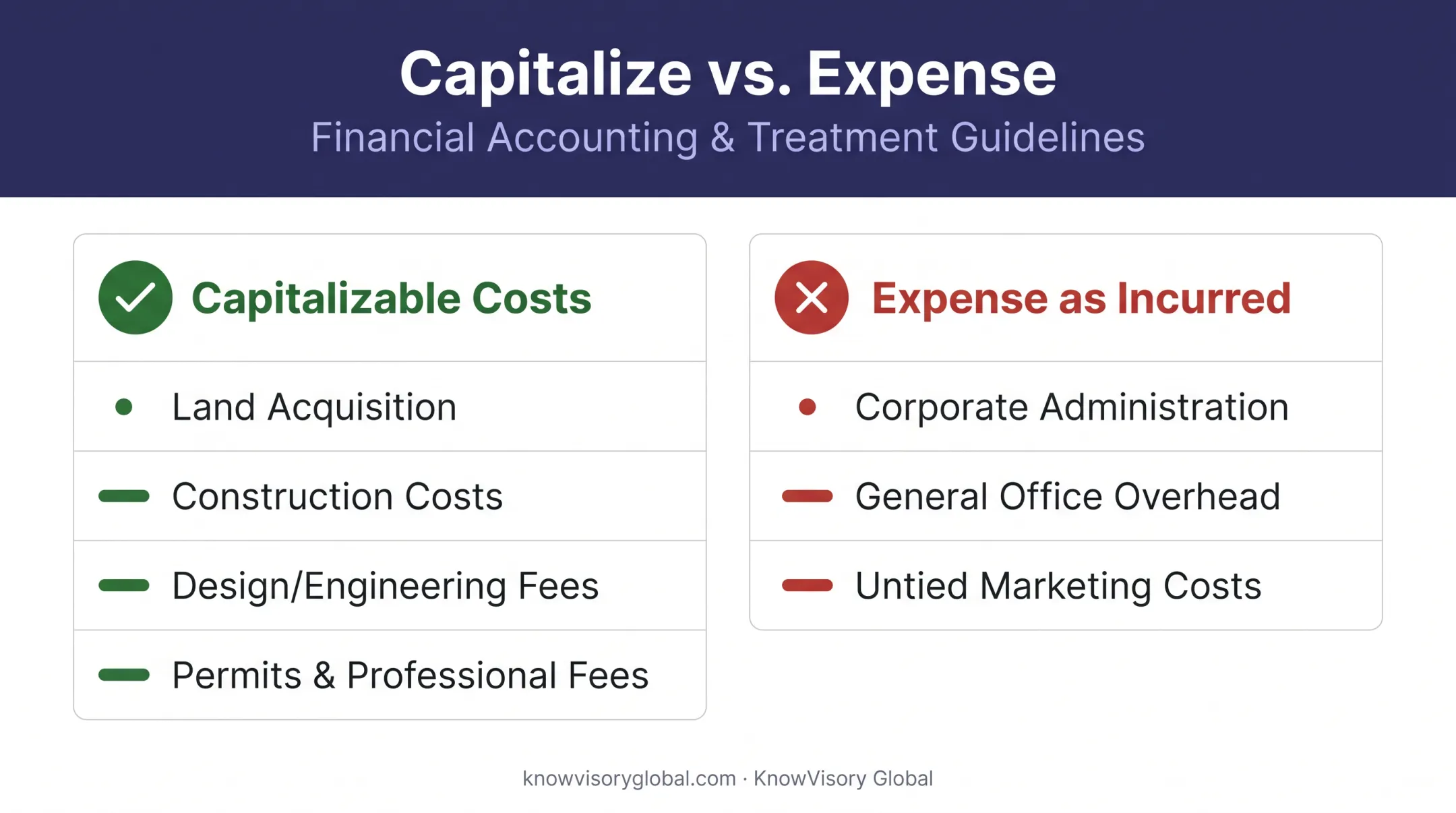

Capitalized versus expensed development costs comparison chart under ASC 970

These lines aren't always obvious. Whether a cost is capitalizable often depends on the developer's specific facts and tax method, so verify treatment before finalizing your policy.

Construction-in-Progress (CIP)

CIP is a temporary holding account. It accumulates eligible project costs until the property is complete or placed in service, at which point those balances move into a completed-asset account, held-for-sale inventory, or a rental property account.

Interest and Financing Costs

ASC 835-20 permits interest capitalization for discrete real estate projects while qualifying development activities are in progress. Capitalization stops once the asset is substantially complete and ready for its intended use.

Not every financing fee qualifies. Distinguish capitalizable borrowing costs from fees that should be expensed, and confirm treatment against current guidance rather than last year's memo.

Job Costing and Cost Categories

Job costing assigns labor, materials, equipment, subcontractors, permits, and overhead to a specific job rather than lumping everything into company-wide books. Within that structure, developers typically track:

Category Example
Hard costs Framing, concrete, roofing
Soft costs Architecture, engineering, permits
Committed costs Signed subcontracts not yet invoiced
Retainage Amount withheld until substantial completion
Change orders Scope or price adjustments to existing contracts

For shared costs across multiple phases or projects, apply a consistent allocation basis, such as square footage, unit count, or labor hours, and document why you chose it.

Accrual Accounting and Matching

Accrual accounting records transactions when they happen, not when cash moves. For developers, that means booking accrued subcontractor invoices, unpaid retainage, property taxes, and prepaid insurance in the period the cost was incurred, regardless of payment timing.

One caution: GAAP and tax capitalization rules are not identical. IRC 263A has its own direct and indirect cost allocation rules for property that's produced, including development and construction. Keep a separate tax capitalization schedule, and involve a qualified CPA before finalizing policy.

Accounting Across the Real Estate Development Project Lifecycle

Every stage of a development project generates different accounting treatment. Getting the sequence right keeps your cost-code structure clean from acquisition through close-out.

Pre-Development and Acquisition

Code and document costs as they hit the books:

  • Land purchase price and closing costs
  • Due diligence, title work, and surveys
  • Feasibility studies and environmental reviews
  • Design, legal work, and permit fees
  • Deposits and entity-formation costs

A speculative builder who buys land, lumber, and fixtures, then builds and sells years later must capitalize those construction costs under IRS rules until sale. Only then do the costs offset the sale price to determine gain or loss—so early cost codes still matter at exit.

Construction Stage

Post each charge to the right project and cost code:

  • Contractor invoices
  • Materials and labor
  • Subcontractor draws
  • Change orders
  • Retainage

Track commitments (signed but unbilled contracts) separately from actual costs so budget-to-actual reports stay accurate.

Monthly Budget-to-Actual Reviews

Run this monthly, not quarterly:

  1. Compare actual spend to budget by cost code
  2. Investigate variances over your materiality threshold
  3. Update the cost-to-complete forecast based on current conditions
  4. Flag whether any change order affects projected margin

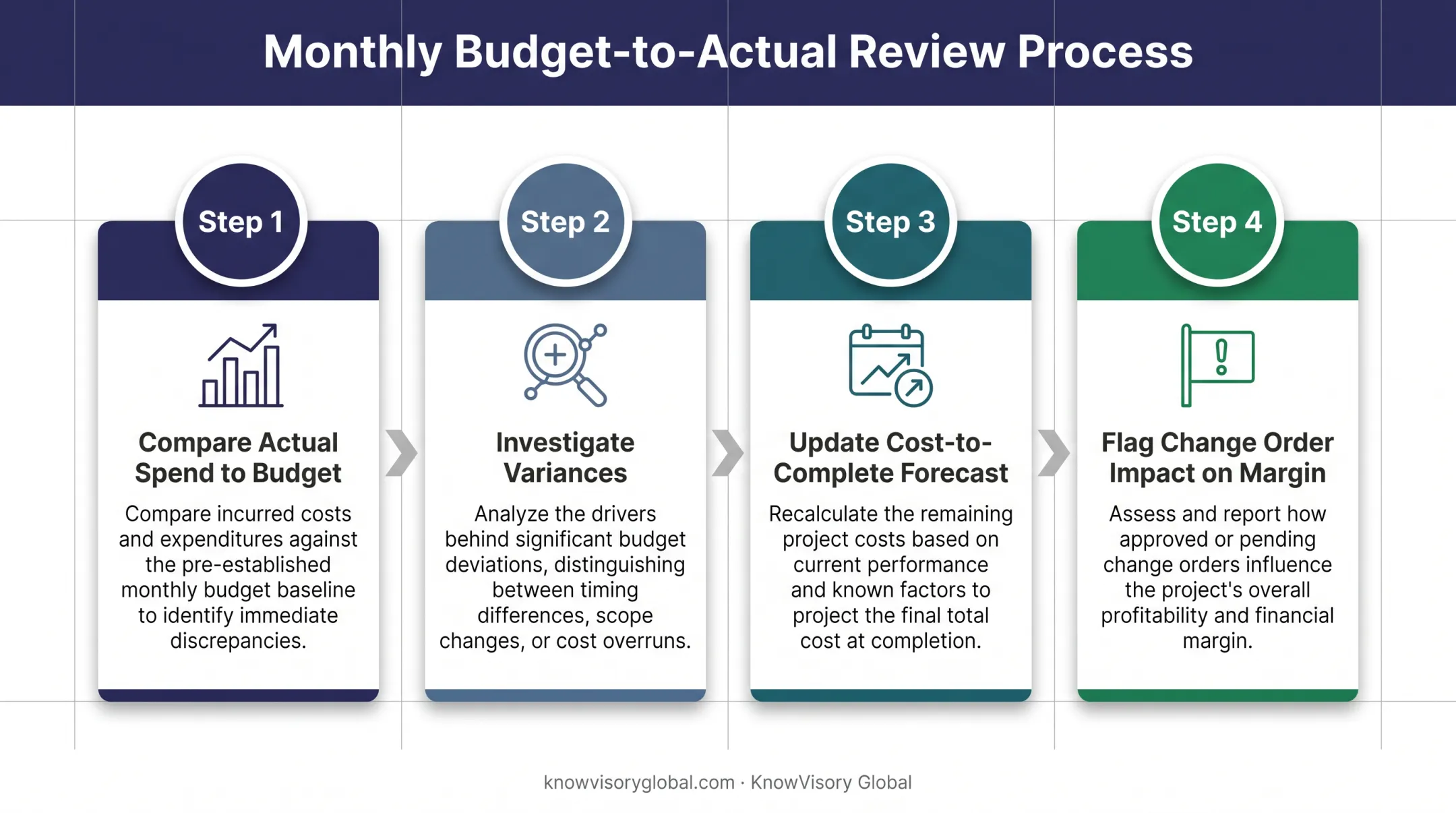

Monthly budget-to-actual review 4-step process for developers

Completion, Sale, and Lease

When a property is ready for its intended use, accumulated CIP costs transfer out. The destination depends on the plan:

  • Held for sale → inventory or held-for-sale asset
  • Held for rent → fixed asset, with depreciation beginning
  • Contribution, sale-leaseback, or entity transfer → apply the guidance for that structure

Revenue Recognition Under ASC 606

Revenue recognition for real estate sales hinges on the contract, performance obligations, and when the buyer obtains control of the asset (KPMG real estate revenue guidance). Some contracts qualify for over-time recognition; most single-asset sales with one closing date recognize revenue at a point in time.

There's no universal method here. Review contract terms, buyer control indicators, delivery conditions, and applicable guidance for every deal type, especially pre-sales and deposit-heavy arrangements.

Project Close-Out

Before you call a project done:

  • Reconcile final vendor balances and remaining retainage
  • Confirm final loan balances with the lender
  • Archive supporting documentation
  • Transfer completed-asset balances and record sale-related closing costs
  • Document lessons learned for the next budget

Financial Reporting, Cash Flow, and Developer Profitability

A profitable project on paper can still run out of cash. This section is about catching that gap before it becomes a real problem.

Reports to Review Monthly

  • Balance sheet and income statement
  • Cash flow statement
  • Project-level profit and loss
  • Work-in-progress schedule
  • Budget-to-actual report
  • Cost-to-complete forecast

Developer balance sheets also carry line items ordinary businesses don't:

  • Land
  • Construction in progress
  • Held-for-sale inventory
  • Project debt
  • Investor equity
  • Deposits from buyers or tenants

Why Profit and Cash Don't Match

Customer payments can arrive 30, 60, or 90 days after invoicing, while payroll, loan payments, and vendor invoices stay due on schedule. Retainage makes this worse: a $100,000 invoice with 10% retainage produces only $90,000 in immediate cash, with the remaining $10,000 held back until substantial completion.

A project can be profitable on an accrual basis and still face a cash shortfall the same month—for example, when a large construction draw is delayed while contractor invoices are already due. The practical fix is a rolling cash forecast: a 13-week model updated monthly, or weekly on tight-margin projects.

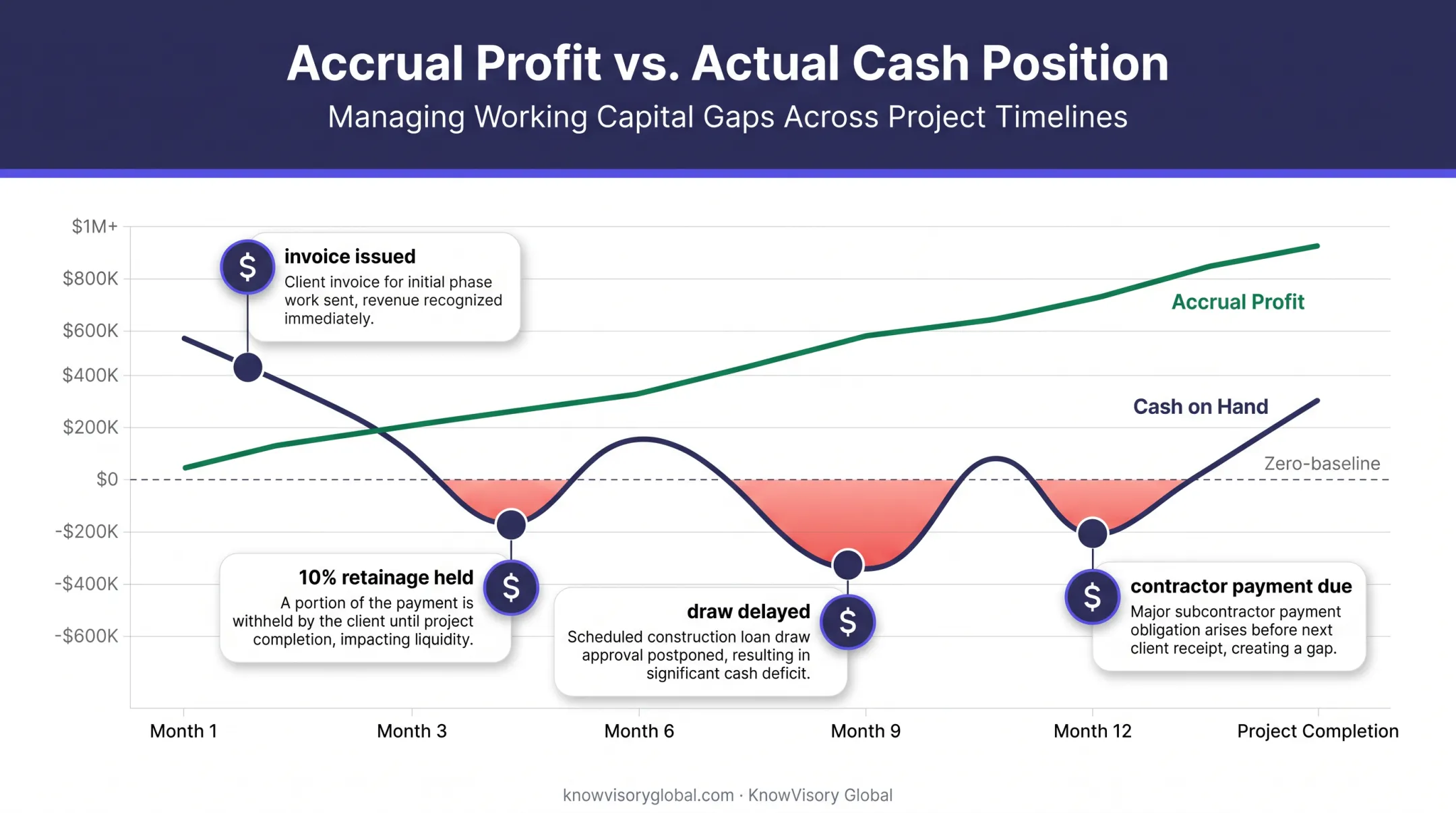

Why project profit and cash flow timing diverge for developers

Metrics That Inform Decisions

Metric What it tells you
Gross project margin Revenue minus total project cost, as a percentage of revenue
IRR Annualized return accounting for the timing of cash flows
NPV Present value of future cash flows at a chosen discount rate
Cash-on-cash return Annual cash flow divided by total cash invested
Debt service coverage ratio Net operating income divided by annual debt service
Cost to complete Remaining spend needed to finish the approved scope

Define these consistently. Don't compare a pre-tax IRR to an after-tax NPV, and don't quote a benchmark you can't source for your market.

Lender and Investor Reporting

Lenders expect reconciled balances, consistent assumptions, and clear explanations for material changes, not just a spreadsheet with updated numbers. A solid draw package reconciles the requested draw to the approved budget, prior draws, invoices, and remaining cost-to-complete. Skip that reconciliation and the draw review—and the loan—can stall.

Accounting Software, Internal Controls, and Outsourced Support

The right system depends on what you're managing, not what's popular.

Software Capabilities Worth Evaluating

  • Project and phase-level cost tracking with customizable cost codes
  • Multi-entity accounting for separate legal entities per project
  • Accounts payable workflows, purchase orders, and retainage tracking
  • Loan tracking and document storage
  • Audit trails and role-based permissions
  • Budgeting, forecasting, and dashboards

Integration matters as much as features. Weak connections between your accounting platform and your construction management, payroll, or CRM systems force duplicate data entry, and duplicate entry is where reconciliation errors sneak in.

There's no single "best" platform. The right choice depends on project size, entity count, construction complexity, reporting requirements, and growth plans.

Tools like NetSuite, Sage Intacct, QuickBooks, Microsoft Dynamics 365, and Xero serve multi-entity organizations differently. Match features to your actual workflow before committing.

Internal Controls Worth Building

  • Documented approval thresholds for contracts, change orders, and draws
  • Segregation of duties between coding, approval, and payment
  • Independent bank and retainage reconciliations
  • Vendor verification before new subcontractor setup
  • A documented month-end close calendar

When Outsourcing Makes Sense

When approval controls and close cadence outgrow your team, outside support is often the practical next step. Outsourcing tends to fit when a developer:

  • Lacks in-house project-accounting expertise
  • Is running multiple active developments at once
  • Needs a faster close without hiring a full internal team

KnowVisory Global supports real estate developers and other SMEs with US GAAP-aligned bookkeeping, reporting, and finance operations that scale as project count grows, without the overhead of expanding an internal team.

Conclusion: Build Accounting Into the Development Strategy

Accurate developer accounting is the system that controls costs, protects liquidity, keeps lenders satisfied, and informs whether you build, finance, sell, or hold. Build it into the development strategy from day one—not as a year-end compliance task.

Start with the fundamentals:

  • Document your chart of accounts
  • Separate records by project and entity
  • Set a monthly close calendar
  • Review capitalization and revenue recognition policies

When transactions get complex, bring in a qualified CPA before you finalize a position, not after. That discipline is what turns accounting into a decision tool for every project you run.

Frequently Asked Questions

How do real estate developers make profit?

Developers generally profit by acquiring or controlling property, improving or constructing it, managing total project costs and financing, then selling or holding the finished asset for rental income. Gross project profit and available cash aren't the same thing, and results depend heavily on market conditions, execution, taxes, and financing terms.

What is the best accounting software for real estate developers?

The best fit depends on project complexity, number of entities, cost-tracking needs, integrations, and reporting requirements. Look for job costing, construction-in-progress tracking, multi-entity reporting, approval workflows, audit trails, and dashboards rather than chasing one "best" brand.

Why is accounting for real estate development different from regular business accounting?

Development projects run for years with delayed revenue, construction commitments, and complex financing that ordinary businesses don't deal with. That means more estimates, work-in-progress balances, and project-level reporting than standard bookkeeping ever requires.

What costs can real estate developers capitalize?

Directly attributable acquisition, development, construction, and certain financing costs may qualify for capitalization. Treatment depends on applicable US GAAP, tax rules, the property's intended use, and its stage of development, so professional review is worth the cost.

How often should real estate developers review project financials?

A monthly close and project review is the baseline for most developers. Increase the frequency of cash, budget, draw, and covenant monitoring when a project is highly active, financially constrained, or going through major scope changes.
